Construction daily report forms: How field teams document daily work

Construction daily report forms: How field teams document daily work

It's 5:45 PM and the superintendent is sitting in his truck, trying to piece together what happened on site eight hours ago from scribbled notes and a fading memory. A construction daily report form is supposed to capture everything: weather, labor, equipment, delays, safety events. But when the form is paper and the day was long, details get lost, entries get vague, and the report that was supposed to document the project becomes less reliable.

That matters more than most field teams realize. In construction disputes, daily reports are commonly cited alongside schedules and correspondence as evidence of what actually happened on site. A report filled out from memory at the end of the week, or a report missing entirely, can affect how well your team supports a delay claim later.

This article covers what a construction daily report form is, why it matters for your jobsite, what a complete template includes section by section, and how to move from paper to a system that works in the field.

What this article covers:

  • The on-site factual record of each project day, written by whoever was there.
  • How quality reports support claims, OSHA compliance, and cost tracking.
  • Ten sections every report needs, from weather to sign-off.
  • The gaps paper and PDF workflows leave behind.
  • A mobile workflow with offline capture, photos, and timestamped reports.
  • Quick answers on who, what, when, and why for daily reports.

What is a construction daily report form

A construction daily report form is a structured document completed on the jobsite each workday. It captures everything that happened during that day's work: site conditions, labor, equipment, materials, progress, delays, and incidents. This is the project's ground-level factual record, written by the person who was physically present.

The form is typically completed by the superintendent or foreman, the senior field supervisor on the jobsite each day. On larger projects, each trade foreman may complete a log for their own crew, with the superintendent compiling the overall site report.

Daily reports don't exist in isolation. They sit alongside RFIs, change orders, meeting minutes, and schedules as part of the documentation set teams turn to for delay analysis and claims. The daily report supplies the date-specific factual account that other documents are cross-referenced against when disputes arise.

One workflow detail directly affects report quality: building the report throughout the day, rather than reconstructing events at 5 PM, produces a more accurate record.

Why daily reports matter on the jobsite

Daily reports matter because they support documentation, compliance, and cost control. Three areas in particular depend on the quality of the daily record.

Claims and disputes

In construction, documentation often shapes outcomes. Delay claims are typically fact-intensive and can involve evaluation of schedules, correspondence, and daily reports from the owner, GC, and subcontractors over long project durations. Reports tend to be more useful when they capture information the day it happens and create a consistent record of manpower, scope of work, and weather conditions.

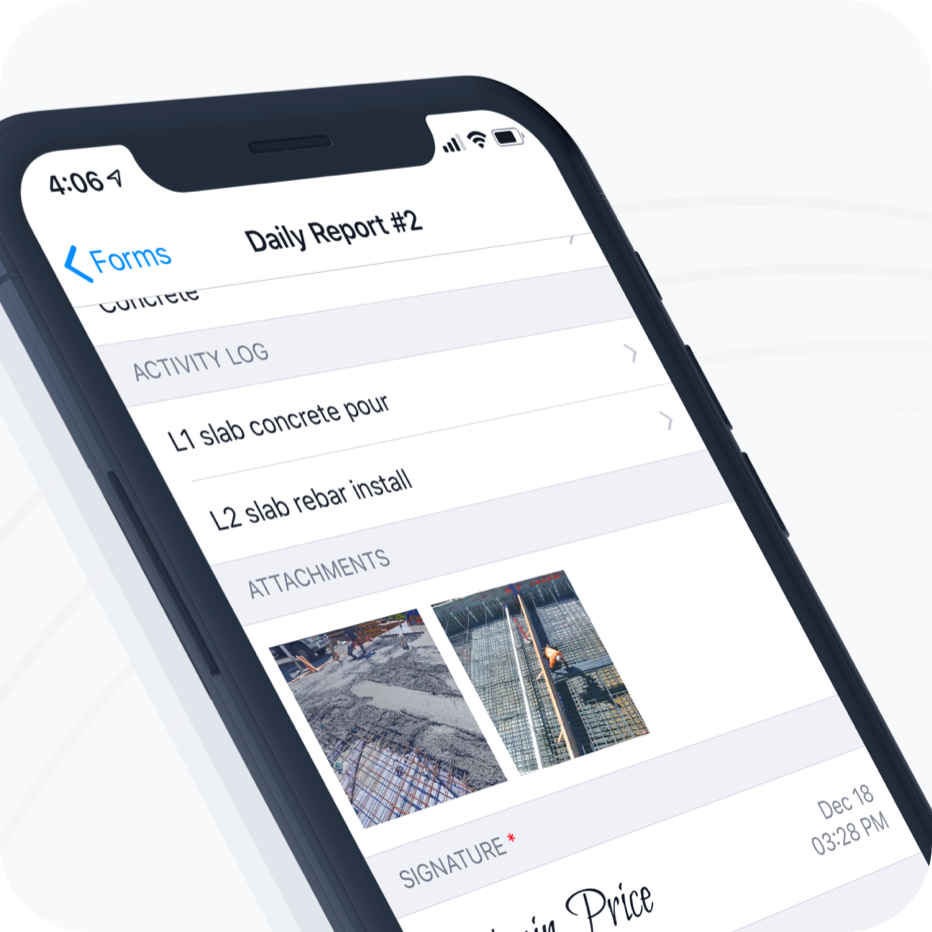

Forms - Daily Reports

OSHA compliance

OSHA 29 CFR 1926.20(b) requires accident prevention programs that include frequent and regular inspections of jobsites. Daily reports that document safety inspections, hazard identification, toolbox talks, and incident observations can help show that those activities were performed.

Cost tracking and billing

Without accurate daily records of labor hours by trade, equipment utilization, and materials consumed, cost tracking gets harder. Change order work performed but not flagged separately from base contract work is also harder to bill accurately after the fact.

What to include on a construction daily report template

A complete daily report template should capture the information your team may need later for claims, billing, and field coordination. Each section below serves a specific legal, financial, or operational purpose, and the entries explain what to record and why it matters.

Fieldwire offers customizable construction forms for daily reports that field teams can complete on mobile devices. If you're building your own template or evaluating what your current form is missing, use this as your checklist.

Project information

Every report needs to be uniquely identifiable and instantly locatable. Record the project name, address, job or project number, sequential report number, date, and the name, title, and employer of the person preparing the report. Sequential numbering is worth calling out. If you ever need to pull records for a claim, a gap in the sequence tells you immediately that a day is missing from the file.

Weather and site conditions

Weather is one of the most important sections because it directly supports delay claims and schedule extensions. Record temperature at morning, midday, and end of day. Record wind speed, precipitation type and duration, visibility, and ground conditions.

A weather entry becomes much more useful when it explains how conditions affected specific work activities. "Overcast, 58°F" is nearly useless as a record. "Overcast, 58°F, 20 mph gusts, crane operations halted 9:00 to 11:15 AM per safety protocol" is a document that supports your schedule claim. Document how the conditions affected the work, not just the conditions themselves.

Crew and labor hours

Record each trade present (carpenters, ironworkers, laborers, electricians), the number of workers per trade, hours worked with start and end times, overtime hours, and any no-shows or late arrivals.

"14 workers on the jobsite" tells you nothing useful for cost coding, productivity analysis, or delay damages. "4 carpenters (8 hrs), 3 laborers (8 hrs), 2 ironworkers (6 hrs, released early due to wind), 5 electricians (8 hrs)" tells you everything.

Subcontractors and visitors on the jobsite

Record every company and person on the jobsite. For subcontractor teams: company name, foreman name, worker count, time on-site, and scope of work performed. For visitors: full name, company, purpose of visit, time in and out, and any instructions or directives issued.

This section matters because verbal directives can later become disputed. A note reading "Owner's rep J. Smith on-site 2:00 to 3:30 PM, verbally directed relocation of electrical panel, awaiting written confirmation" prevents a dispute over who authorized the change.

Equipment used

Record equipment type, unit number, operator name, hours of operation, tasks performed, and idle time with the reason. If you're renting a crane and it sits idle for three hours waiting on a concrete delivery, that idle time should be in the daily report. Also record equipment that was expected but didn't arrive. That's a delay cause, and it needs to be in the record.

Materials delivered and used

For deliveries, record material type, quantity with units, supplier, delivery ticket and PO number, time of delivery, condition on arrival, and where materials were staged. For materials consumed, record type, quantity, and location of installation.

Always note damaged or non-conforming materials the day they arrive. If you accept a delivery of bent rebar and don't document it until a week later, you've lost your leverage with the supplier. Record short deliveries explicitly: "Ordered 200 CY concrete, 185 CY delivered per ticket #4471."

Work performed

Work performed is one of the sections most often referenced when schedules are disputed, so specificity carries the most weight here. Document each work activity tied to specific grid lines, floor levels, or room numbers. Include quantity completed with units (LF of pipe, SF of drywall, CY of concrete placed), percentage complete, and work continuing the following day. Flag change order work separately from base contract work.

"Poured concrete" is not a record. "Placed 185 CY of 4,000 PSI concrete at Level 2 slab, Grid Lines A through F, Activity #2.3.1" is evidence you can use in a schedule dispute six months from now.

Delays, issues, and safety incidents

This section documents the causes of lost time and any safety events that occurred on site that day. For delays: description, cause, exact start and stop times, trades and activities affected, mitigation steps taken, and who was notified. For safety incidents: type (near-miss, first aid, recordable), time, location, persons involved, corrective action, and whether OSHA reporting is triggered.

Never leave this section blank. Write "No delays today" and "No safety incidents." A documented statement of fact reads as a complete record, while a blank section looks like an oversight.

Why your Excel construction daily report form may be creating more cost than you realize

Photos and supporting documentation

Photos support every other section and can be especially useful when written records alone are disputed. Photograph work in progress and work completed tied to specific log entries, material deliveries (especially damaged items), equipment on the jobsite, weather conditions causing delays, and concealed work before it's covered.

Captions matter as much as the photo itself. "IMG_4471.jpg" means nothing two years from now. "Level 3 slab rebar inspection, Grid A to D, prior to concrete pour, 10/15/24, passed by inspector J. Torres" is evidence.

With Fieldwire, teams can attach photos to forms or tasks from the field.

Signature and sign-off

The preparer (foreman or superintendent) signs with printed name, title, and date/time of completion. Include a brief next-day plan and any open action items requiring follow-up.

Aim to complete and sign the report at the end of each workday, not the following morning. A report finalized while the day's events are fresh is generally more reliable than one reconstructed days later.

Where paper and PDF forms fall short

Paper daily reports require field information to be re-entered in the office, duplicating much of the data entry. Photos taken on phones often become disconnected from the report they're supposed to support. And when a report doesn't get turned in, paper systems typically generate no alert, so a missing day stays invisible until someone goes looking for it during a claim, months or years later.

The result is a record full of holes: vague entries written from memory, photos no one can find, and gaps that make miscommunication and rework harder to untangle after the fact.

How Fieldwire handles daily reports in the field

Daily reporting is one of the workflows Fieldwire handles directly from a phone or tablet.

Using Fieldwire's digital forms for daily reports, project teams can standardize reporting for field users on mobile devices. The foreman on site fills out the form as the day progresses, attaches photos taken in the field, and submits when the day wraps. The office team can review it without waiting for paper to come in from the trailer.

Reports also work offline, so crews in basements or areas with poor signal can still document and update work. Updates sync when connectivity returns.

Here's what that looks like in practice: a foreman doing a slab pour at Level 2 opens the daily report form on a tablet at the start of the day. The weather is automatically logged, and the foreman records the crew at 7 AM. Throughout the day, they snap photos of the rebar inspection at 9:30 AM and attach them directly to the form, note a 45-minute delay from a late concrete truck at 11:15 AM, and then close out the form with a signature at 4 PM. The PM in the trailer sees the entries as they happen and the photos already paired with the right day.

For closeout and claims, Fieldwire generates timestamped construction reports representing a chronological history of tasks, photos, forms, and attached files. That's the kind of organized, date-stamped record that helps teams answer questions later.

If your daily reports are still on paper, Fieldwire is the digital tool that gives field teams and office staff a shared view of plans, tasks, and jobsite documentation, so everyone's working from the same page.

Frequently asked questions about construction daily report forms

Usually the superintendent or foreman completes it, though on larger projects each trade foreman may log their own crew's work and the superintendent may compile the overall record.

At minimum: project information, weather and site conditions, labor, subcontractors and visitors, equipment, materials, work performed, delays and safety incidents, photos, and signatures.

Ideally throughout the day and finalized at the end of the workday, while details are still current.

They provide the day-by-day factual record used to compare schedules, correspondence, change orders, and other project documents when disputes arise.

Fieldwire lets teams complete custom forms on mobile devices, attach photos, work offline, and generate timestamped reports without the paper filing process.

Courtney Bottos

With 7 years of hands-on experience in roles from Project Engineer to Project Manager, Courtney brings a real understanding of the challenges and pressures that construction teams face in the field each day. As a Construction Success Manager at Fieldwire, this experience allows Courtney to help customers create a higher level of efficiency and improve coordination and communication across their project teams.

Get started now

Field service management software for construction

4,000,000+ projects worldwide

Helping the largest construction companies in the world more easily manage their job sites.

Graham UKEllisDonClark ConstructionBuiltClimatec logoBrookfieldCougnaudWebcorJohnson ControlsMorguardBockmon & WoodySutter HealthColt BuildersSpeller MetcalfeGraham
