Construction plan management software: keep every drawing current, accessible, and marked up

Your concrete crew poured to the drawing on their tablet Tuesday morning. The structural engineer revised that sheet Friday afternoon, and the updated set has been sitting in a project manager's inbox ever since.
Construction plan management software exists to stop the field from building from yesterday's information while the latest revision sits somewhere else. The bill for it arrives weeks later as rework. Superseded drawings and poorly communicated design information can send crews back to work they thought was already complete.
Plan management software has to keep drawings current and accessible while preserving markups for closeout. Those requirements give teams a practical way to judge whether any given tool will hold up in the field.
What this article covers:
- A plan management system replaces scattered paper sets with one revision-controlled source of truth on every device.
- Outdated drawings drive rework, field confusion, and recurring print costs long before closeout.
- Version history plus in-field sheet comparison lets crews catch changes before they build to the wrong revision.
- Offline-first access and role-based permissions put the right sheets in front of the right people, signal or not.
- Field markups pay off at closeout when they carry across revisions and export as a layered, attributed record.
- Plan pins tie tasks, RFIs, photos, and punch items to the exact spot on the drawing where the work happens.
- A field-ready BIM viewer lets crews confirm dimensions and spot spatial conflicts at the point of work.
- Six practical checks separate software that holds up on a live jobsite from software that only looks good in a demo.
What is construction plan management software?
Construction plan management software is a system for distributing and versioning project drawings with markup tools so every person on a jobsite works from the same current set. It replaces the trailer plan table and the half-size paper sets scattered across the site with one cloud-synced source of truth, accessible from a phone or tablet, with full revision history behind every sheet. Strong software also anchors field work directly to plan locations. The drawing becomes the organizing layer for field work.
Why outdated drawings cost you
Superseded drawings show up first as rework and field confusion, then add paper reprocessing work.
Rework from working off superseded sets
Direct field rework routinely consumes a meaningful share of total construction costs, and the share depends heavily on project type. The Construction Industry Institute, the research body that has tracked this cost category for decades, treats it as one of the most persistent and hardest-to-eliminate line items in construction.
Design errors and omissions, including inaccurate and outdated drawings, are among the most consistently cited contributors. Poorly communicated and poorly coordinated design information can create construction errors before work starts. When a crew builds to last week's spec, the information pipeline created the error before anyone picked up a tool.
Redlining and version confusion in the field
Version count multiplies fast, and every extra version is a chance for someone to redline the wrong one. A project with 200 drawing sheets and six revisions creates 1,200 document versions circulating among the project team. Missed revisions can create downstream schedule and cost problems, especially when teams lack a clear revision log. Paper redlines make it worse: the marked-up trailer set never matches what field crews are holding.
Reprint and reprocessing costs
Every revision cycle on paper means reprinting and redistributing full or partial sets. On the $285M Jim Pattison Children's Hospital project, GC Graham reported saving $35,000 on printing costs alone after moving plan management off paper. The underlying problem is universal: any project still working from paper ends up reprinting and redistributing a full set every time even a handful of sheets change.
Keeping plans current: version control and revision history
"Current" should mean field-ready change visibility, not just a baseline distribution rule. Uploading the new set and superseding the old one covers the first half of the problem; version comparison also has to happen on the jobsite. The crew in the field needs the ability to check what changed, on the spot, before work starts.
That means the software has to handle two things: superseding older versions without losing the markup history attached to them, and making sheet references navigable so nobody flips through a hundred pages to find one detail. In Fieldwire, this runs through slip-sheeting with OCR-based title block recognition, and callouts activate automatically as clickable links between sheets after upload.
Live, in-field comparison is the piece a baseline version-control system often misses. A foreman standing on the slab needs to overlay two revisions and see the differences before the crew picks up a tool, not review a change log back at the trailer. Fieldwire's Sheet Compare (Pro and above) does this on mobile, showing matching content in greyscale and differences in color.
Two more mechanics worth checking for in any plan management tool:
- Automatic callout hyperlinks, so a detail reference jumps straight to the referenced sheet.
- Tasks that follow the revision automatically, so existing field work stays linked to the current drawing instead of orphaning when a sheet updates.
Subcontractors using Fieldwire have reported 18% fewer rework incidents and 25% faster punch list closure compared to paper-based workflows. The underlying mechanism is what matters regardless of tool: fewer crews building off dead drawings means fewer tear-outs.

Keeping plans accessible: mobile, offline, and role-based access
Real accessibility has two layers that a feature checklist can miss: the plans have to work where there's no signal, and the right people have to see the right sheets.
Offline reliability is an architecture decision, not a feature toggle. Software built offline-first treats the local device as the primary data source and uses connectivity only for syncing, so plans, tasks, markups, and photos keep working in a basement mechanical room or a rural site with no bars. Fieldwire is built this way; when the connection returns, changes sync automatically across devices, with content timestamped and photos carrying date, time, and GPS data on Pro plans and above. That architecture matters because if the one sheet a crew needs isn't cached locally, "works offline" is theoretical.
Access also depends on permissions. A real project mixes GC supers, subs, architects, and inspectors, and each group needs different access to the plan set: some need to upload and manage plans, others need to markup and create tasks, and others just need to view assigned work without touching anything else.
Markup that becomes the record
A markup made in the field should end its life in the as-built package. When the record lives on a paper set in a truck, it rarely makes closeout easier. Once you treat a markup as the first draft of the as-built rather than a scratch note, the markup tools start earning their keep.
That requires two things from the software: a full markup toolset that works on mobile, and markups that carry forward automatically when a drawing revises, so the record never resets. Fieldwire supports text, lines, shapes, freeform lines, highlighters, clouds, arrows, and photo and video attachments pinned to plan locations, plus linear and area measurements after scale calibration; when a new drawing version uploads, existing markups transfer to the newest sheet automatically.
Closeout is where markup tools earn their value, because the field record becomes part of the owner handoff package. The export needs to preserve each markup as an attributed layer, with creator and date information, and keep task, photo, and RFI links clickable rather than flattening everything into a static image. In Fieldwire, selecting "Export plans" produces a PDF or ZIP that does this, and as-built drawings build up throughout the project rather than getting assembled in a scramble at the end. A companion closeout report in PDF or CSV pulls photos, task information, and plan markups into one document.
Visibility works differently here too. In many platforms, a markup stays local until someone takes an extra step to publish it to the rest of the team, which adds friction and is easy to forget mid-task. In Fieldwire, markups are shared with the project by default. A note drawn on a wall is visible to the superintendent or the office the next time they open the plan, no extra step required. If there's a markup worth keeping to yourself, Fieldwire also lets you mark it private instead.
Plans as the anchor for tasks, RFIs, and punch lists

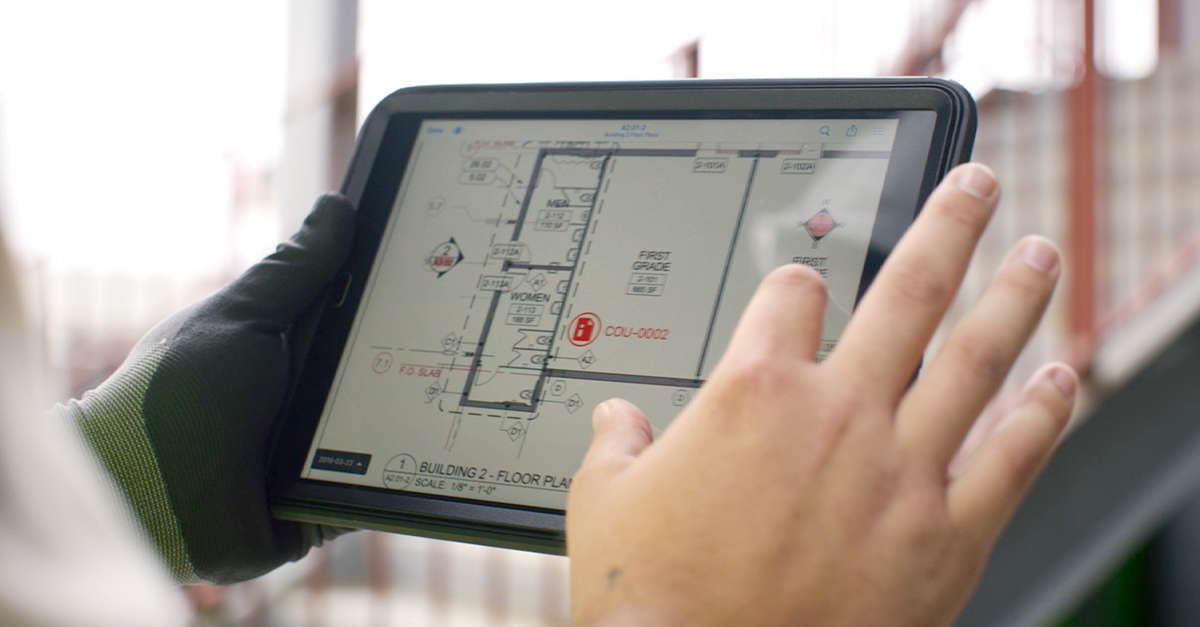

Plan management software turns the drawing into the workspace, not just a reference document. That means field tasks get created by dropping a pin directly onto a plan location rather than describing the location in text.
That removes the translation step that kills paper and spreadsheet workflows. When a task lives on the drawing, pinned to the exact wall, room, or mechanical chase where the work is located, nobody interprets a vague description like "fix the electrical issue near column C" and walks to the wrong spot. In Fieldwire, the whole flow takes three taps: drop a pin, attach a photo, assign it with a due date and priority, and each pin carries its own conversation, checklist, photos, and attachments.
The same logic extends to formal questions and punch work. A field question tied to a pin can escalate into an RFI without losing the location context, and punch items benefit from the same two-step verification workflow as any other task, ideally with pins droppable offline and syncing once connectivity returns.
A punch list with 50 items is manageable on paper. Fifteen thousand items across a hospital project isn't. At that scale, spatial anchoring, tying every item to an exact plan location, becomes the system.
BIM and 2D/3D integration
For projects running BIM, plan management software needs to put the model in the same hands holding the 2D plans, not keep it in a separate authoring tool the field never opens. That means crews should be able to switch between a 2D sheet and the 3D model of the same location, take measurements to verify clearances, and tap objects for material and dimension metadata, all from a mobile device.
Fieldwire's BIM viewer supports IFC files up to 1 GB and combines multiple trade models into a single federated view, with tasks, measurements, and section cuts available directly in the model. The point of a field-ready BIM viewer isn't model authoring; it's letting a crew confirm a dimension or check a spatial conflict at the point of work instead of calling the design office.

What to look for when evaluating plan management software
Six criteria separate software that survives the field from software that survives the demo:
- Field adoption without mandated training. If the crew won't open the app in week three, nothing else matters. Start by involving people with field experience, including project managers and superintendents, along with trade partners.
- Offline reliability. Test mobile and offline performance before committing. Ask whether offline is the default architecture or a pre-download workaround.
- Live version comparison in the field. Can a foreman overlay revisions on a phone before starting work?
- Markup-to-as-built export. Can markups export as a layered, attributed record, or does closeout require manual reassembly?
- Pricing transparency. Review whether pricing is based on users, projects, modules, or bundled capabilities your field teams may not need.
- A genuine mobile app. Field tools need native mobile workflows; a mobile website or shrunken desktop screen will slow crews down.
Run these six checks against a live project, not a staged demo. The tool that clears all six is the one your crews will still be opening in month three. Fieldwire is one option built around these same criteria, with a free tier for small teams if you want to run the checklist yourself before committing further.
Frequently asked questions about construction plan management software
Invite people when they need to act on the drawing. GC supers and trade foremen need access before field work starts, architects and inspectors need a clean way to review conditions, and clients or specialty trades may only need visibility at defined milestones. Set permissions around the job each group has to do: maintaining the plan set, creating the field record, or reviewing assigned work.
Make the check part of the pre-task routine for pours, installs, and inspections. Assign one person to open the sheet on a field device, compare the active revision against the prior one, confirm any pinned work is still sitting on the right location, and document that the crew has acknowledged the change before tools come out.
Run the test like a dead-zone rehearsal. Put the device in airplane mode, open a plan, add a markup, photo, task, checklist, or form, then reconnect and confirm the changes appear on another device with the right timestamps. A workflow that depends on remembering to preload one missing sheet needs more testing before field use.
Treat the export as an owner handoff package ready for review. Before final delivery, open the PDF or ZIP, verify that markups can be reviewed by layer with creator and date information, check that multiple sheets read as one coherent plan set, and click through the task, photo, form, and RFI links that are supposed to remain active.
Most construction plan management software prices by the number of users rather than by projects or sheets, though not universally, since some tools price by project or data volume instead. Fieldwire, for reference, is free for small teams within set limits, with paid tiers starting at $39 per user per month and rising as you add reporting, custom forms, integrations, and the BIM viewer. When you compare options, ask what the base license actually includes and whether exports, storage, or integrations cost extra, because bundled add-ons are where the real price usually hides.
Plan management is a focused slice of document management. Document management covers every project file, submittals, contracts, specifications, and correspondence, while construction plan management software centers on the drawing set: distributing it, versioning it, marking it up, and keeping the field on the current revision. You need both on a real project, but the plan set is where field work actually happens, so it deserves tools built for markups, revisions, and offline access rather than a shared folder.
